Primary Settling Tank’s 8, 9 & 10 Rehabilitation at the Back River Wastewater Treatment Facility

Project Location
Back River WWTP – 8201 Eastern Ave, Baltimore, MD 21224
Construction cost
Grout, rebar, Lab testing, and labor costs excluded - $280,037 Lump Sum, $176.12 per FT
Construction Start/End
July ’24 – Dec ’24 (estimated to have taken 1+ year if performed traditionally)

Details

When was it constructed and how long has it been in service:

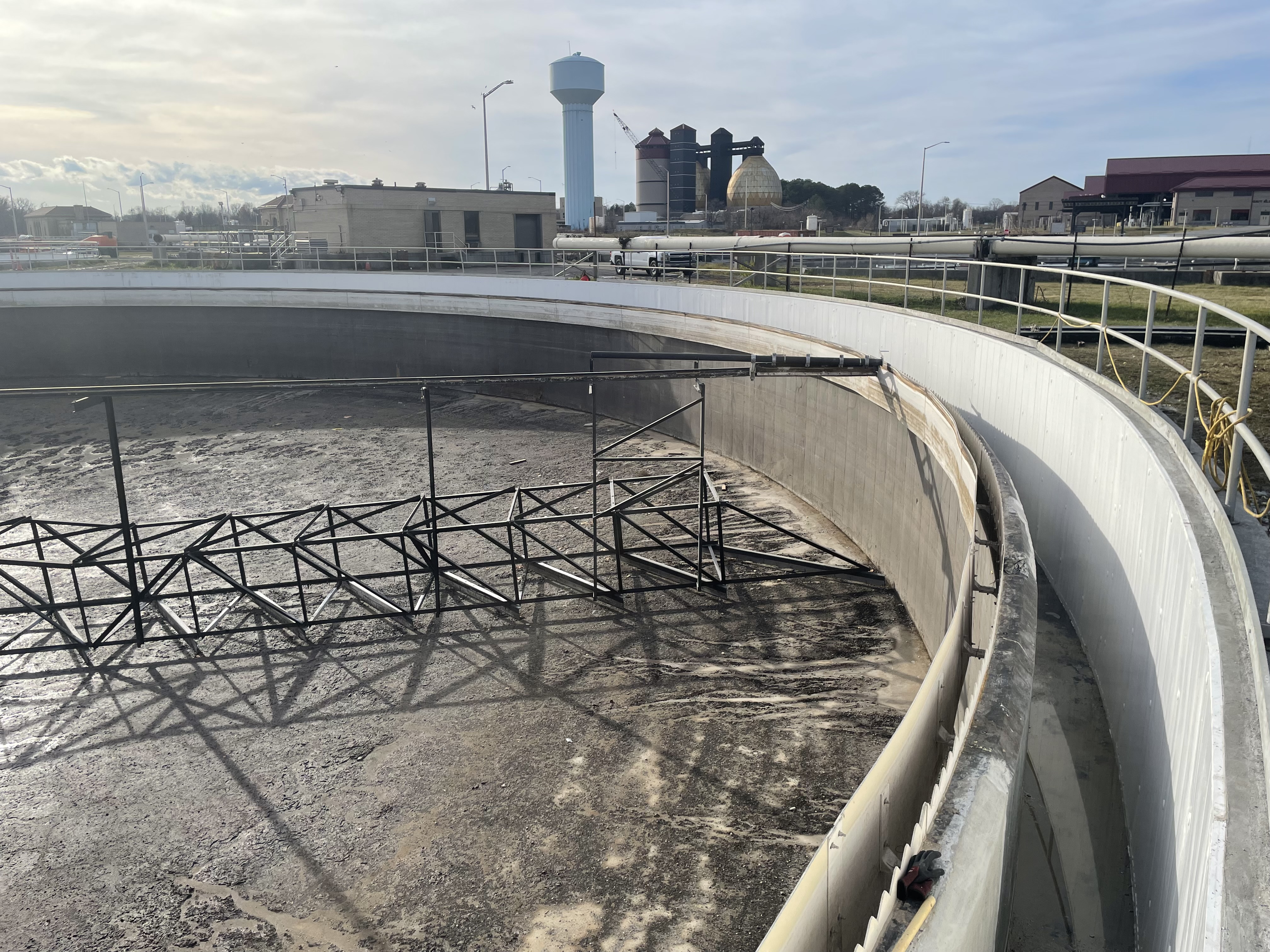

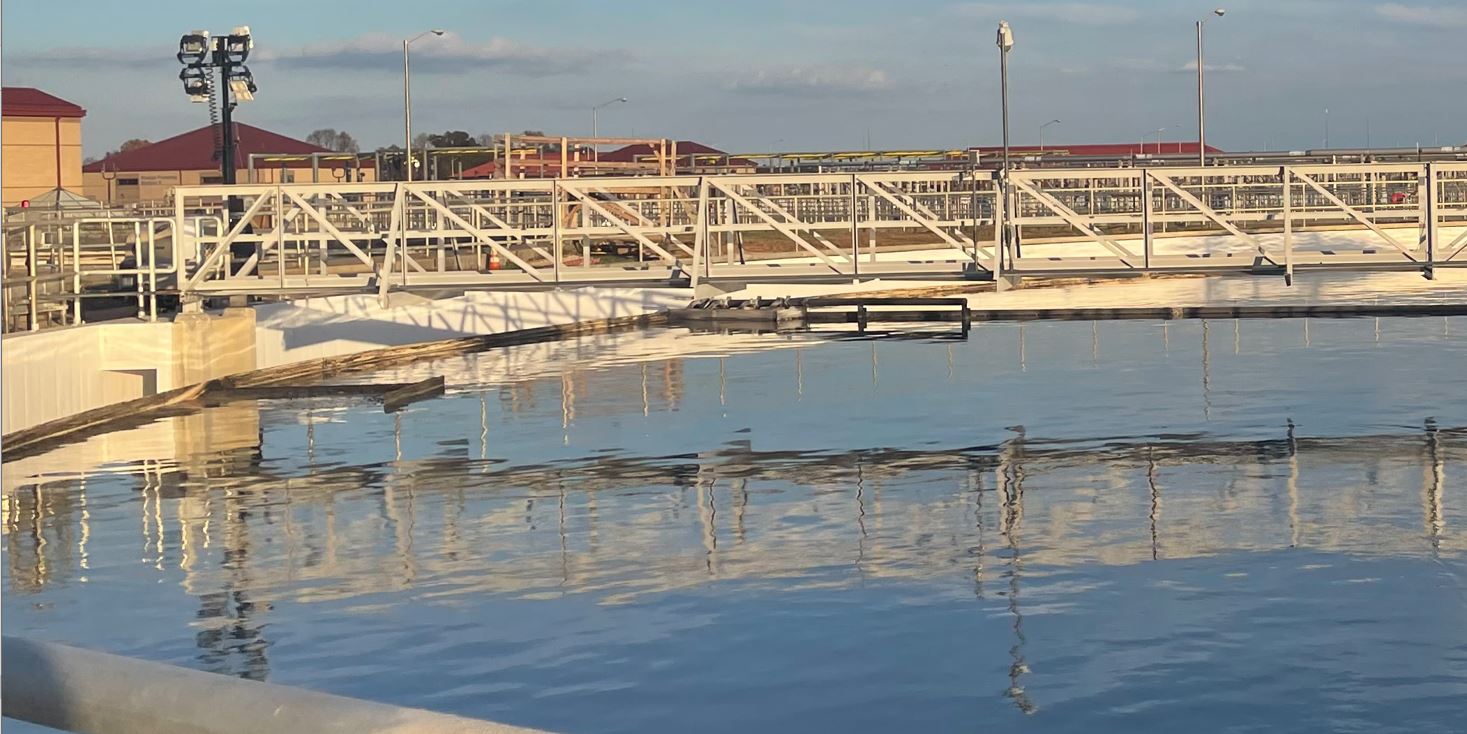

(3) PS tanks were formed and poured out from 8/1/24 – 12/17/24 and have been in service since January. The month of July was used to prep/cut materials and clean the first tank.
Dimensions:

Circumference of PSTs = 530ft each (area covered by Danby liner)
Height of Danby panels – 8’3”

Depth of pipe:
N/A
Depth of ground water:
N/A
Health and safety:
None
Has any re-inspection been performed? What was the condition of the pipe?

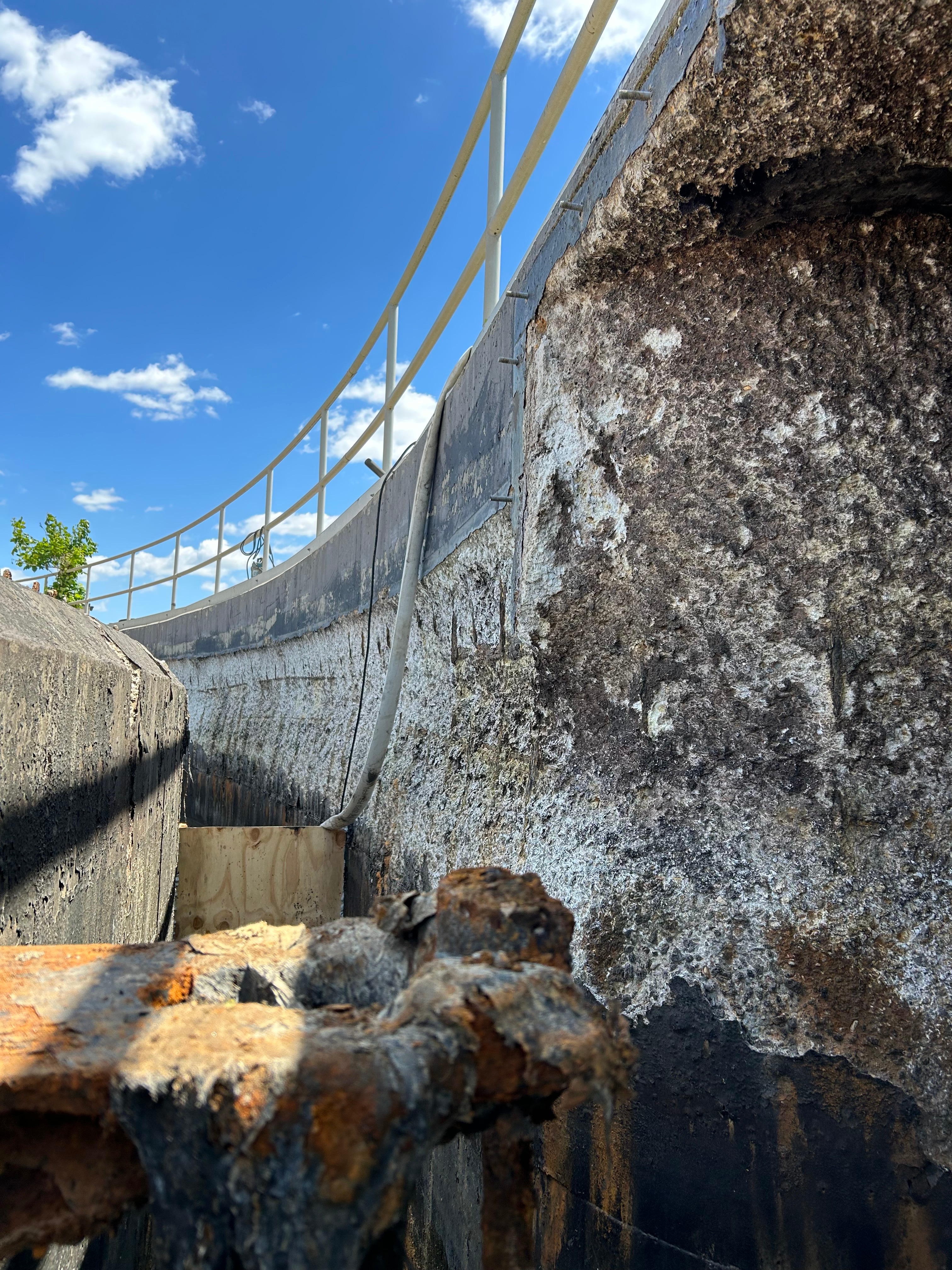

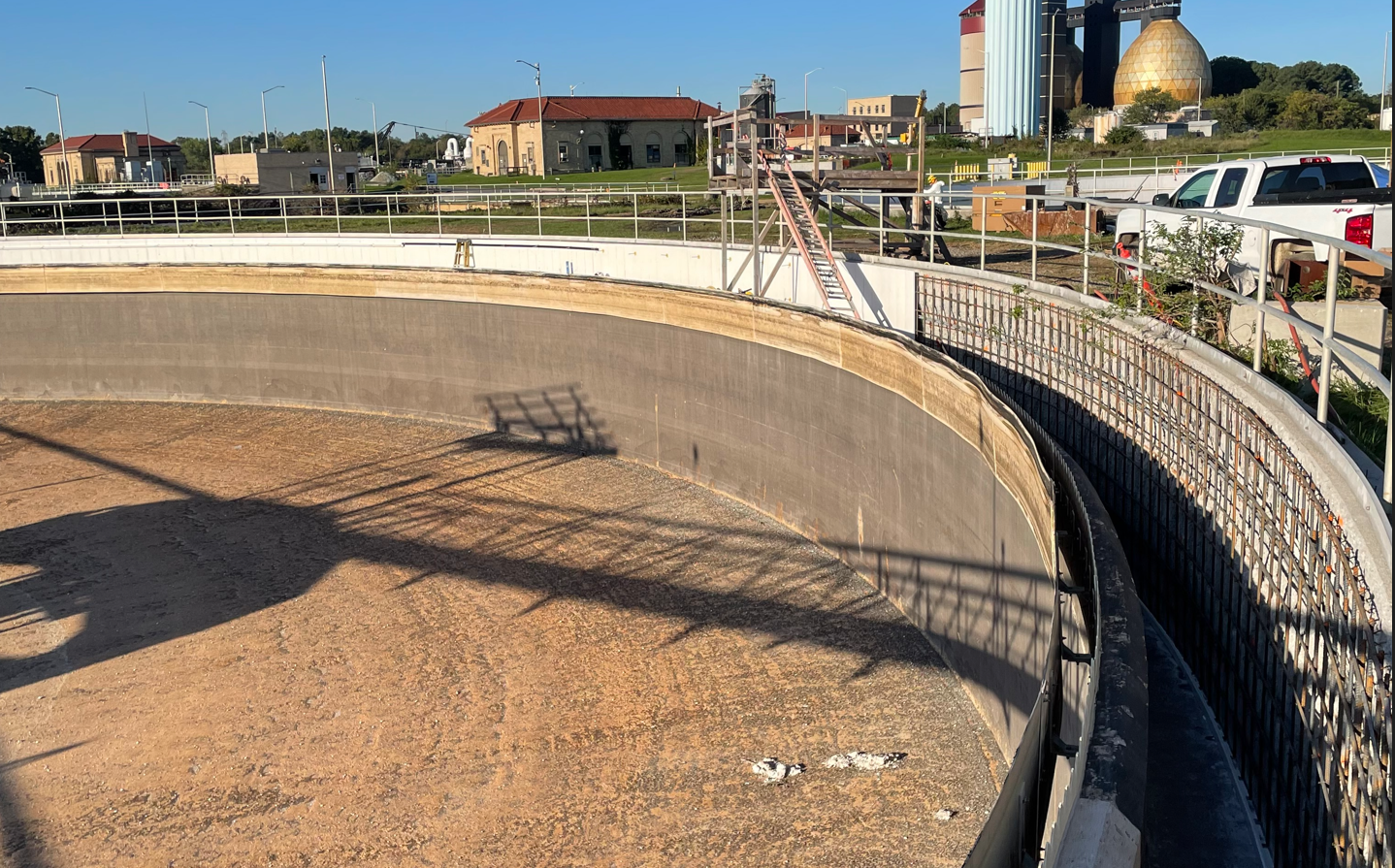

Tanks have been visually observed from outside and no deterioration is present.
References

Ryan Allen, Construction Project Supervisor l
City of Baltimore
Ryan.Allen@baltimorecity.gov
410-236-4244

Methodology

Ventilation and odor control used:
N/A – open tanks
Rehab method used:

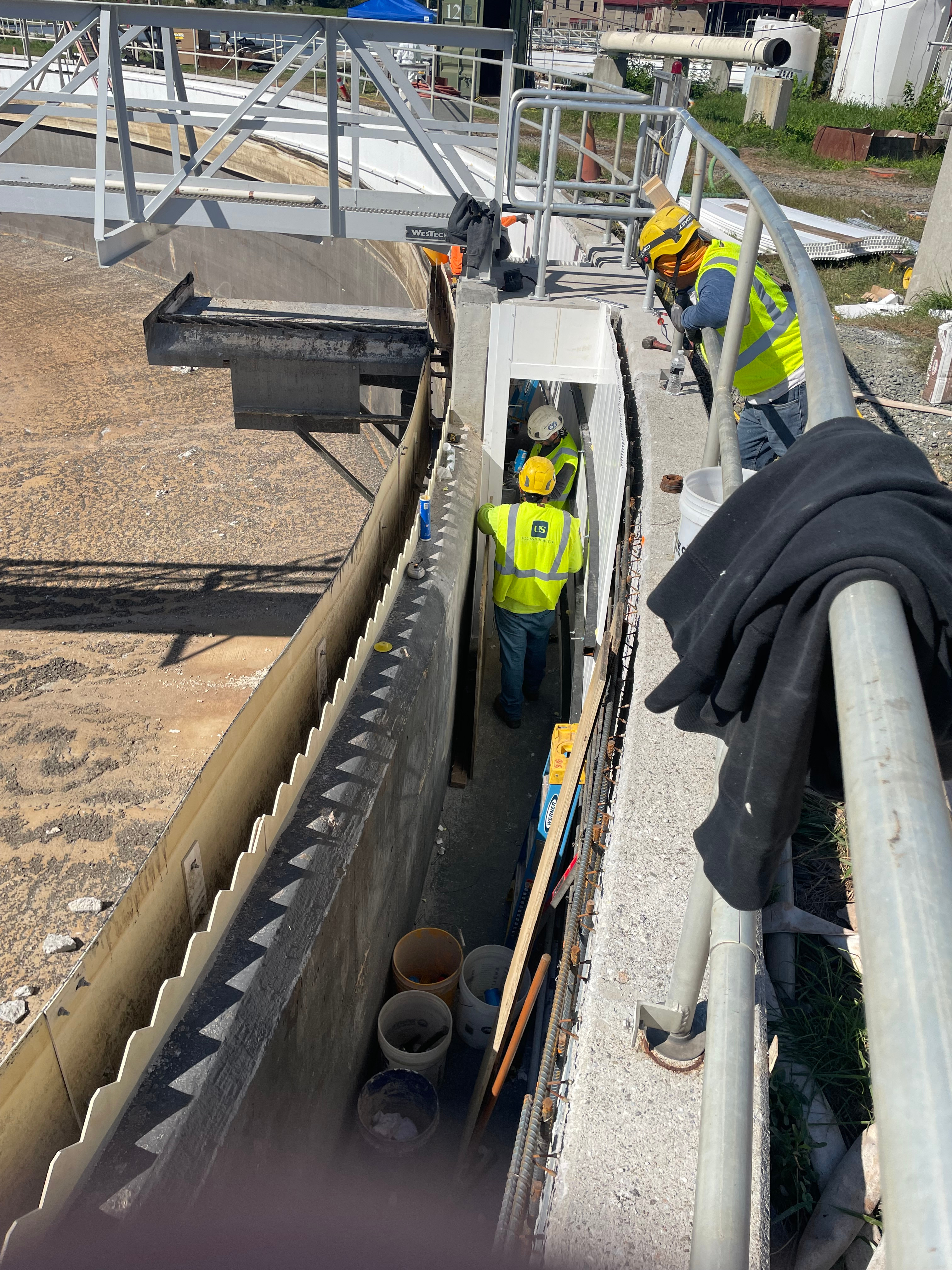

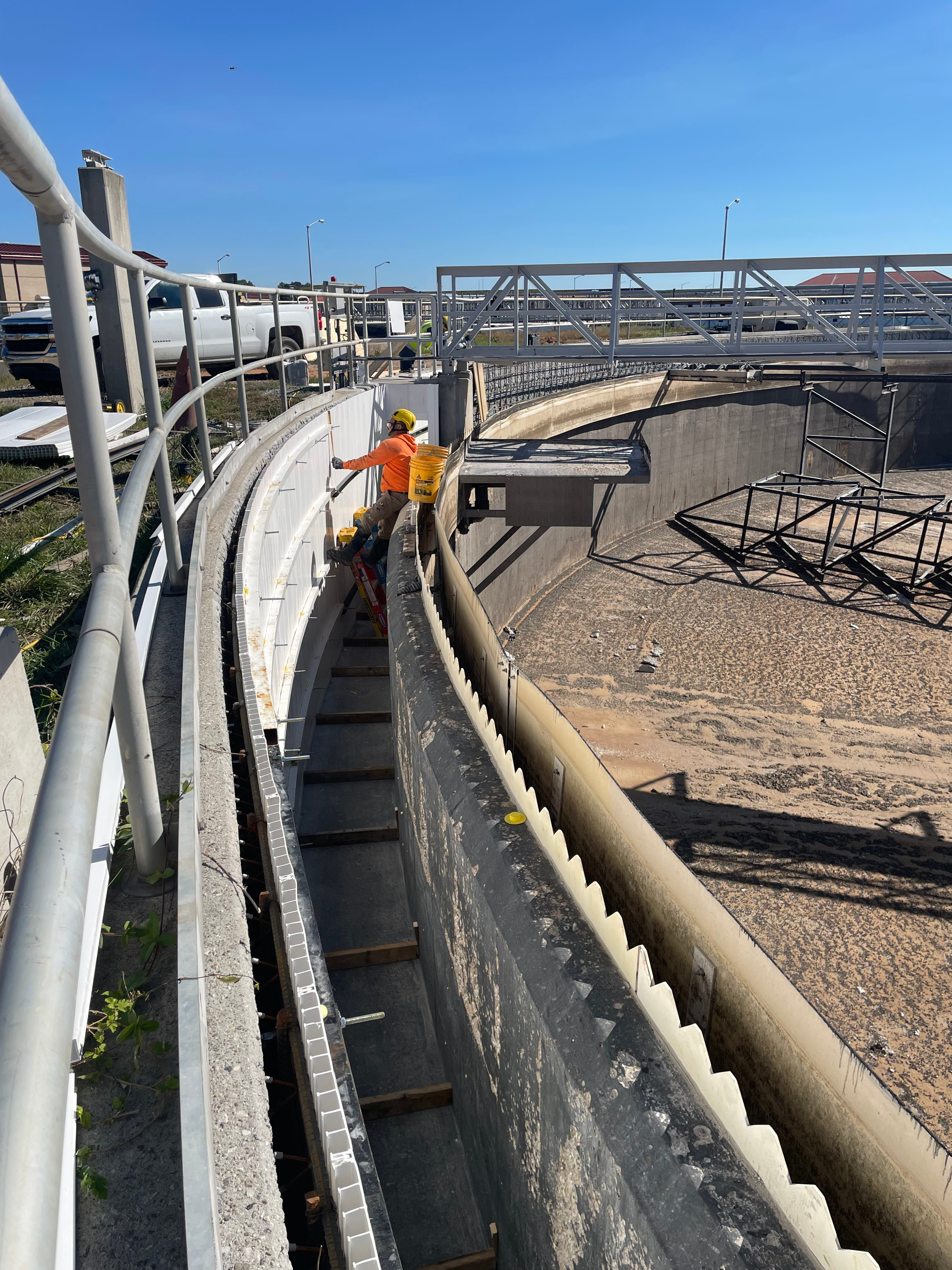

1” Flat Panels installed vertically, SS supports horizontally, #5 rebar @ 12” EW on the interior face.
Cleaning method used (if required) and who cleaned the line:
Heavy duty pressure washer (40k psi) to clean the PST walls
Method of flow bypass or diversion, if used:
N/A, tanks were drained ahead of work.

Hurdles

Problems encountered during construction:

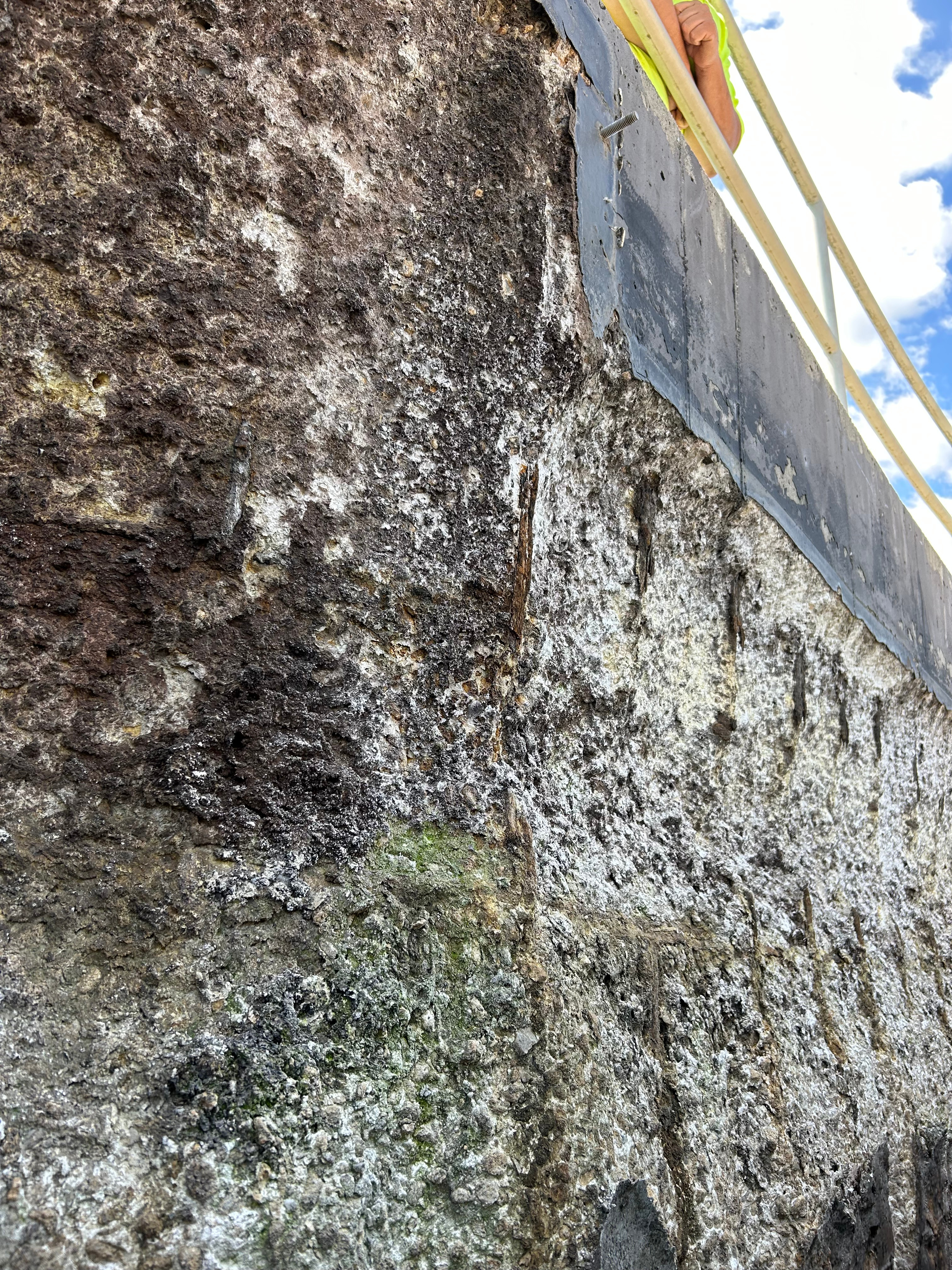

During first lift of grout on some sections, minimal leakage through the bottom, added some kicker supports and issue was solved.
Problems encountered after construction:
None
